Justified AI Campus: Fluor EPC and Fiber Scope
AI & Data Centers

Justified AI Campus: Fluor EPC and Fiber Scope

July 7, 2026

Join Low Voltage Nation — Find project opportunities and showcase your company to thousands of industry professionals

Learn More →

Fluor has signed the three-building EPC for TeraWulf’s Justified campus. Review the power conditions, credit support and prospective low-voltage work.

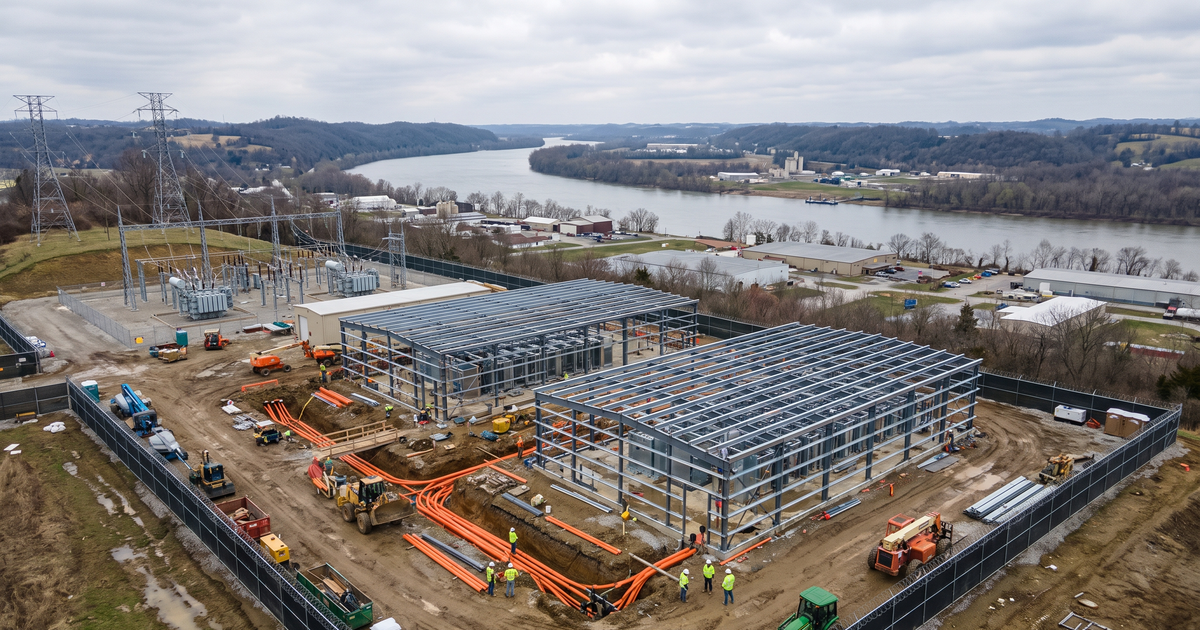

TeraWulf’s Justified Data Campus in Hawesville, Kentucky, has a clearer construction delivery chain. On November 4, the owner announced a definitive agreement with Fluor Enterprises for engineering, procurement, construction, testing and commissioning of three data center buildings. Its phased service forecast now runs from late 2027 through the second quarter of 2028. TeraWulf’s announcement establishes a substantial execution milestone for contractors following the campus.

Fluor separately confirms that early works have begun. Electrical, fiber, structured cabling, security and controls subcontractors remain unnamed in the reviewed evidence. That combination gives low-voltage firms a practical reason to prepare their qualifications while keeping estimating and crew commitments tied to an actual scope, buyer and release date.

The project in view

The development reuses the former Century Aluminum industrial site in Hancock County. TeraWulf’s August 24 power-agreement announcement describes an estimated $4.0 billion to $4.5 billion for site development and initial data halls, excluding customer computing equipment. The earlier utility proceeding cited a $3.5 billion to $4 billion estimate. These are separately dated development estimates, with no verified definitive EPC price in the November announcements.

MeasureReported positionQualification
LocationHawesville, KentuckyIndustrial-site redevelopment
Delivery scopeThree buildingsEarly works confirmed
Leased critical ITApproximately 401 MWFuture phased delivery
Utility contract demandUp to 482 MWService conditions apply
Initial lease term20 yearsAnthropic tenant
Service forecastLate 2027–Q2 2028Completion unverified

The lease and capacity figures are described in TeraWulf’s November 4 Form 8-K. The utility framework is documented in the Kentucky Public Service Commission’s August 21 order. Current energized AI capacity has not been established by the evidence reviewed for this update.

What the EPC agreement changes

Fluor’s November statement advances the relationship beyond the limited notice to proceed announced in March. Fluor expects to recognize the award in the fourth quarter after finalizing pricing for the first two buildings. It describes cost-overrun exposure limited to a percentage of its profit. TeraWulf calls the agreement GMP-based and says maximum pricing is being established as engineering and procurement progress. A fully fixed construction price should therefore remain unassumed.

For a specialty contractor, the useful change is a named organization coordinating a broader delivery scope. The next commercial questions are specific: which entity buys the package, which building is included, who supplies equipment, where responsibility changes between civil, electrical and communications work, and what constitutes acceptance? A campus-wide announcement rarely answers those questions at the detail needed for a reliable estimate.

Early works also require careful interpretation. The reviewed announcement supports activity on site, but it supplies no building-by-building completion percentages or detailed permit inventory. Before treating a phase as ready for low-voltage mobilization, confirm that its work fronts, access, pathways and predecessor tasks are released. The published delivery window provides planning context; a contractor still needs the package schedule and its dependencies.

Who has a supported role

The parties below come from the owner’s announcement, the Form 8-K and the PSC order. Their roles help locate the commercial and technical interfaces. Company participation alone does not establish a specialty installation award.

OrganizationSupported roleBoundary
TeraWulfOwner and developerCampus delivery
Fluor EnterprisesThree-building EPCSpecialty awards unknown
AnthropicLease tenantCapacity delivered in phases
Raylan Data LLCLease landlordNamed legal counterparty
Justified DataPowerProject subsidiaryElectric-service agreement party
Google LLCConditional credit supportDelivery-linked effectiveness
Big RiversWholesale procurementMISO supply framework
KenergyRetail electric deliveryRESA terms apply
Owensboro Community and Technical CollegeReported training partnerPSC-recorded owner statement

The legal names matter when pursuing work. Raylan Data LLC is the landlord named in the filing; historical references to similarly named affiliates should be checked against the actual contracting document. Fluor’s EPC engineering role also does not independently identify an engineer of record for every discipline. A useful first conversation resolves authority and package boundaries before discussing price or availability.

Power, leases and credit support

The 401 MW figure describes leased critical IT load. The 482 MW figure describes maximum demand under the retail electric service arrangement. These measures apply to different parts of the project. Neither figure alone establishes current server operation, usable electrical capacity on a particular construction date, or a cable quantity. Avoid calculating a campus efficiency ratio from these headline numbers without a common measurement boundary and operating basis.

The PSC order, available through case 2026-00115, describes wholesale procurement through MISO by Big Rivers and retail delivery by Kenergy. Page 17 requires the necessary MISO approvals, transmission rights and operational arrangements before the RESA becomes effective. Current satisfaction of those conditions was not independently verified. Utility agreement approval also provides no substitute for checking construction, environmental and occupancy permissions relevant to a particular package.

The approximately $19 billion announced in July represents expected contracted revenue over the initial lease term. It should be kept separate from development cost, construction contract value and financing proceeds. TeraWulf’s July lease announcement supplies that commercial context. A contractor assessing payment and mobilization needs the terms of its own agreement and evidence of the relevant funding and release conditions.

The November filing says Google’s backstop becomes effective at commencement of the final data hall under each corresponding lease. It contains termination provisions and default-related alternatives. The signed agreements do not establish that Google is currently a tenant, lender or equity owner. A completed project debt closing and its amount remain unverified in this review. These distinctions help explain the financing framework without turning a conditional commitment into cash already available for construction.

Where low voltage could enter the work

The following opportunities are LVN’s practical inferences for an AI/HPC campus. The reviewed documents do not establish issued specialty scopes, quantities, named carriers, installation awards or bid dates. Use the table to prepare questions and capabilities, then replace assumptions with the issued specifications.

SystemPotential workEvidence needed
Fiber and outside plantRoutes, entrances, testingCarrier and pathway designs
Structured cablingPathways, labels, terminationIssued quantities and standards
Access control and CCTVDoors, gates, video integrationSecurity package and buyer
Fire alarmInterfaces and acceptanceApproved life-safety design
BMS and controlsPoints, alarms, commissioningControls responsibilities
Operational networkingFacility-system connectivityIT/OT responsibility split
Grounding and bondingTelecom-space coordinationElectrical detail and QA plan

For fiber teams, useful early questions concern route ownership, building entrances, pathway handoff and testing responsibility. Determine who accepts the duct system, who supplies the cable, how connector inspection is documented and which test results the owner requires. These are estimating inputs. There is no verified campus strand count, route length, carrier diversity arrangement or approved product list to price from this article.

Security and controls teams should clarify interfaces just as early. Door hardware, fire-alarm release functions, network ports, power supplies and software configuration can cross multiple contracts. Prepare a responsibility matrix that names who installs, configures, tests and signs off each interface. For controls, request the points list and acceptance sequence. For networking, establish ownership of addressing, configuration and operational handover before promising an integrated result.

Phased turnover deserves its own estimate review. A package may require repeated mobilization, temporary protection, retesting after adjacent trades, or work near systems already accepted by the operator. Ask how those conditions are scheduled and paid. Identify the required document format, labeling convention, test-file naming and closeout approval route before field installation creates a large reconciliation task.

Jobs, training and a credible approach to procurement

Page 21 of the PSC order records TeraWulf’s expectation of approximately 90 to 100 or more direct operating employees, with potentially similar additional tenant employment. It also reports a training partnership with Owensboro Community and Technical College through KCTCS-TRAINS. These are owner representations in the utility record. The reference to 60 people at a hiring event counts attendees; it does not establish 60 hires. Current campus vacancies and a confirmed construction workforce total were not verified.

Fluor’s careers site and Owensboro Community and Technical College provide general research routes. Check the actual job location, employer, requisition and prerequisites before treating any listing or training program as a Justified opportunity. Prospective applicants can prepare a concise work history showing installation tasks performed, instruments used, test documentation produced and experience coordinating with other trades.

The Fiber Optic Association’s workforce resources explain pathways into design, installation, splicing and testing. For this project, those resources support general preparation; no campus-specific certification requirement was verified. An employer evaluating a technician should ask for demonstrated practice in cleaning, inspection, handling and documenting optical work, then compare that experience with the actual issued scope.

Fluor’s supplier and contractor portal accepts company profiles and expressions of interest. Fluor explicitly says the portal provides neither bid opportunities nor qualification. A firm can prepare its capabilities, relevant references and accurate service geography, then verify the appropriate procurement contact and requirements. Registration alone gives no basis to announce a bid invitation, prequalification or award.

The milestones worth watching next

The most useful next evidence would narrow a specific uncertainty: finalized EPC pricing, phase-level construction progress, satisfaction of utility conditions, a financing close, or a named electrical and low-voltage package buyer. For subcontractors, issued drawings and a procurement schedule would be more actionable than another campus-wide capacity headline. Each should be checked for its building, scope and effective date.

Justified now offers a stronger construction signal through the named EPC and confirmed early works. Specialty firms can use that information to improve readiness while keeping the work forecast conditional. Review the sources, prepare the relevant capability statement and follow LVN Signal for project intelligence that connects development milestones to practical contractor questions.

Updated November 5, 2026. Featured and social artwork are AI-generated conceptual illustrations. Building layouts, equipment and progress depicted in them are illustrative.

#project-spotlight·#ai-data-center·#data-center·#signal-content·#video-source·#hawesville·#kentucky·#terawulf·#fluor·#under-construction
