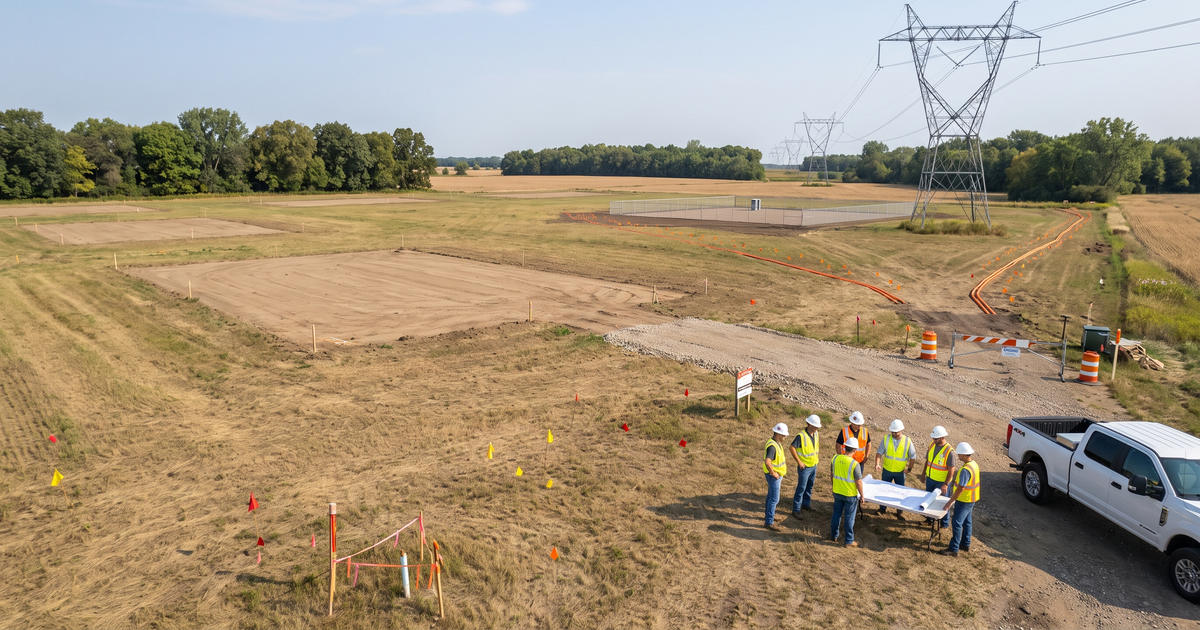

Monticello Tech's revised Minnesota filing outlines a planned 547-acre, $1 billion-plus data-center campus with Xcel 345 kV studies, a future substation, explicit diverse-fiber requirements, and major construction awards still unresolved.

Monticello Tech LLC has returned to the City of Monticello, Minnesota, with a revised application for a large new data-center campus south of 85th Street and east of Highway 25. The City's current project page says it received the second submission on August 3, 2026 and is reviewing it for completeness. No public-hearing date, Planning Commission recommendation, City Council decision, site-plan approval, building permit, construction award, or verified field mobilization appears in the current public record.

The resubmission is still an important construction signal. The current DCPUD application narrative covers approximately 547 acres, including about 370.2 acres proposed for Data Center Planned Unit Development zoning. It retains a planning range of roughly 2 million to 3 million square feet across approximately five to ten principal buildings and states more than $1 billion of private investment. Those figures describe an entitlement and infrastructure program, while tenant-specific buildings and trade packages remain deferred.

Project factCurrent detailBoundary
StagePlanned / completeness reviewNo approval or mobilization.
Subject siteAbout 547 acresCity overview rounds to 550.
DCPUD areaAbout 370.2 acresZoning request area.
Building plan2-3 million square feetTenant footprints are deferred.
Private investment$1 billion-plusApplicant statement / lower bound.
Public infrastructureAbout $73.5 millionSeparate developer-funded estimate.
Campus capacityNot disclosedBackup limits are not IT load.

Area figures should stay in their own lanes. The filing describes an approximately 547-acre subject site and about 370.2 acres in the proposed DCPUD district. The City's public overview rounds the broader campus description to approximately 550 acres. LVN does not turn the 370.2-acre zoning request into total site area, and it does not use the rounded 550-acre figure as a surveyed parcel measurement.

Building area is also a planning range. The August narrative says the proposal needs approximately 2,003,000 square feet to satisfy the stated floor-area-ratio requirement while preserving a 2-million-to-3-million-square-foot scenario. It assumes about five to ten principal buildings of approximately 200,000 to 400,000 square feet, plus support facilities. Final footprints, phasing, data-hall layouts, rack density, critical load, and tenant design standards are expected to arrive through later site-plan and building-permit records.

The $1 billion figure is a documented lower bound rather than a final construction budget. The same filing separately estimates approximately $73.5 million for public streets, sanitary sewer, stormwater systems, and watermain work. It says those public improvements would be funded by the developer or end user. The private-investment statement and public-infrastructure estimate should not be added together or substituted for an awarded contract value.

The current schedule remains conditional. The application uses Q1 2028 through Q4 2030 as a planning window for public infrastructure and campus buildout, while another section allows sequential construction over four to eight years. The City is still deciding whether the August 3 submission is complete. Those planning assumptions are not notices to proceed, binding completion dates, or evidence that building packages are available for bid.

The permitting sequence is substantial. The City's data-center review history shows adoption of the Monticello Industrial Alternative Urban Areawide Review in January 2026 and approval of a local DCPUD ordinance in April. The current campus still needs a completeness determination, annexation steps, rezoning, conditional-use and preliminary-plat review, a public hearing, Planning Commission and Council action, development agreements, tenant-driven site plans, final plat sequencing, utility approvals, and building permits.

The final AUAR evaluated a 3-million-square-foot technology-campus scenario and identifies Monticello Tech LLC as proposer, Nick Frattalone as contact, and Kimley-Horn as the environmental and planning consultant. The AUAR is useful project-family evidence, but it does not replace the pending land-use review or award construction work. Current status comes from the August resubmission and the City's live project page.

OrganizationSource-backed rolePursuit signal
Monticello TechDeveloper / applicantEntitlement and procurement updates.
Frattalone CompaniesApplicant representativeDeveloper-side and civil signals.
Kimley-HornPlanning / civil consultantSite and infrastructure packages.
Xcel EnergyUtility / study lead345 kV and substation milestones.
City of MonticelloLand-use authorityHearings, agreements, and permits.
AE2SCity water consultantWater-system review.
Bolton & MenkCity sewer consultantSanitary-system review.
WSBAUAR review consultantEnvironmental coordination.

Monticello Tech is the source-backed developer and land-use applicant. The current land-use application names Nick Frattalone at Frattalone Companies' office and domain as the applicant representative. Frattalone's company site describes earthwork, demolition, underground-utility, and energy construction capabilities. That supports a developer-affiliate and applicant-representative connection. The reviewed filing does not separately label Frattalone as the campus general contractor, so LVN does not present it as a GC award.

Kimley-Horn has the clearest project-specific consultant role. It authored the current application narrative and supporting planning, civil, environmental, entitlement, and infrastructure materials. Its mission-critical portfolio provides relevant company context. The evidence supports a planning and infrastructure-design role, while no reviewed record names Kimley-Horn as GC, electrical contractor, low-voltage integrator, or commissioning authority.

Power planning is moving through Xcel Energy. The application says Xcel completed a system-impact study and is conducting a facilities study targeted for December 2026. The concept uses the local 345 kV transmission system, future system upgrades, and a future Xcel-owned substation shown on the current preliminary plat. The filing does not disclose total campus MW or delivered IT critical load, and backup-generation thresholds are not a substitute for those values.

That power sequence creates future work around substation communications, protection and controls, SCADA and EPMS integration, industrial fiber, grounding and bonding, relay testing, switchyard access control and CCTV, metering, alarm routing, energization, functional testing, and commissioning. Award timing will depend on the facilities study, route and interconnection decisions, utility design, long-lead equipment, land-use approvals, site permits, and the eventual division of work among Xcel, the developer, end user, electrical contractors, and specialty integrators.

Low-voltage laneCurrent project signalQualification focus
Fiber / OSPDiverse carrier pathwaysRoutes, duct banks, splicing, tests.
Structured cablingMulti-building campusBackbone, pathways, labels, QA.
SecuritySecurity buildings and perimeterAccess, CCTV, gates, VMS.
Fire / life safetyTenant-driven halls and BESSInterfaces, acceptance, records.
Controls / OTSubstation and facility systemsBMS, EPMS, SCADA, segmentation.
DAS / radioLarge hardened buildingsCoverage and AHJ requirements.
Grounding345 kV and campus pathwaysBonding, testing, coordination.
CommissioningPhased future buildoutIST, turnover, training, closeout.

Telecommunications requirements are unusually explicit for a project this early. The application calls for multiple independent telecommunications pathways, carrier diversity, physical route separation, high availability, maintenance isolation, and infrastructure that can scale with future demand. That creates a credible outside-plant lane around carrier entrances, diverse campus routes, duct banks, vaults and handholes, high-count fiber, splicing, optical-loss and OTDR testing, route records, and coordination with road, utility, wetland, fence, and substation work.

Inside future buildings, likely qualification questions include campus backbone topology, meet-me-room and telecom-room pathways, high-density fiber, support copper, racks and cabinets, ladder rack and cable tray, labeling, test limits, redundancy, tenant handoff boundaries, operational-network segmentation, spare capacity, and electronic closeout. These are practical pursuit categories supported by the filing's resilient-network requirements. Public sources do not provide strand counts, connector types, manufacturers, quantities, rack layouts, tenant standards, or an awarded structured-cabling package.

Security scope will extend from the site perimeter to controlled mission-critical spaces. The campus program allows security buildings and perimeter controls, and a multi-building technology campus will require coordinated visitor, vehicle, contractor, and operations access. Future packages can include gates, intercom, credentialing, access control, CCTV, video management, storage, perimeter detection, monitoring, and acceptance testing. The actual platform, integrator, device count, retention policy, cyber standard, and division-of-work boundary remain undisclosed.

Fire and life safety must eventually coordinate data halls, support buildings, backup generation, battery systems, mechanical yards, and utility infrastructure. Practical scope includes initiating and supervisory devices, suppression interfaces, releasing logic where applicable, door and HVAC control, emergency communications, generator and BESS monitoring, supervising-station paths, cause-and-effect testing, special inspection support, and authority acceptance. The filing does not name a fire-alarm manufacturer, contractor, design firm, or final tenant standard.

Controls and operational technology will connect facility, electrical, environmental, and security systems across a phased campus. Contractors should be prepared for BMS, EPMS, SCADA, protection and controls, segmented fiber networks, metering, alarms, time synchronization, historian data, point-to-point checks, failover, cybersecurity coordination, functional performance testing, and structured turnover. The current public record does not identify control platforms, protocols, point counts, integrators, or the responsibility matrix.

Grounding, bonding, and commissioning will cut across every package. Telecom pathways, racks, cabinets, entrances, substation systems, electrical rooms, security equipment, controls panels, and building systems must share documented reference and test practices. Readiness includes calibrated fiber and copper test equipment, cleaning and inspection discipline, labeling standards, QA/QC records, device checks, fire and security acceptance, network failover, integrated systems testing, issue closure, operator training, BIM coordination, and electronic closeout.

The current application does not publish a controlling construction-job or permanent-job count. That means workforce planning should focus on confirmed scope and procurement milestones instead of repeating unsourced employment totals. Useful readiness paths include BICSI optical-fiber training, BICSI copper training, FOA workforce resources, and OSHA outreach training. Project onboarding may later add site safety, lift access, background screening, bonding, insurance, prequalification, manufacturer authorizations, and mission-critical references.

The next actionable signals are the City's completeness determination, public-hearing notice, Planning Commission recommendation, City Council action, annexation, development agreement, site plan, final plat, building permits, and procurement releases. On the infrastructure side, watch Xcel's facilities study, the 345 kV route and upgrade plan, substation design, interconnection agreements, equipment orders, energization, and commissioning. The end user, operator, architect, GC or EPCM, electrical contractor, carriers, fiber and structured-cabling teams, security and fire-alarm integrators, controls vendors, DAS contractor, and commissioning authority remain open questions.

Bottom line: Monticello Tech is a high-confidence planned data-center project with a current municipal resubmission, a large documented land and building program, a $1 billion-plus applicant investment statement, source-backed developer and engineering roles, Xcel power studies, a future substation, and explicit redundant-fiber requirements. It also remains at the application-completeness stage. The strongest low-voltage opportunity is early intelligence and qualification work ahead of later site-plan, utility, bid, award, construction, energization, and commissioning milestones.
