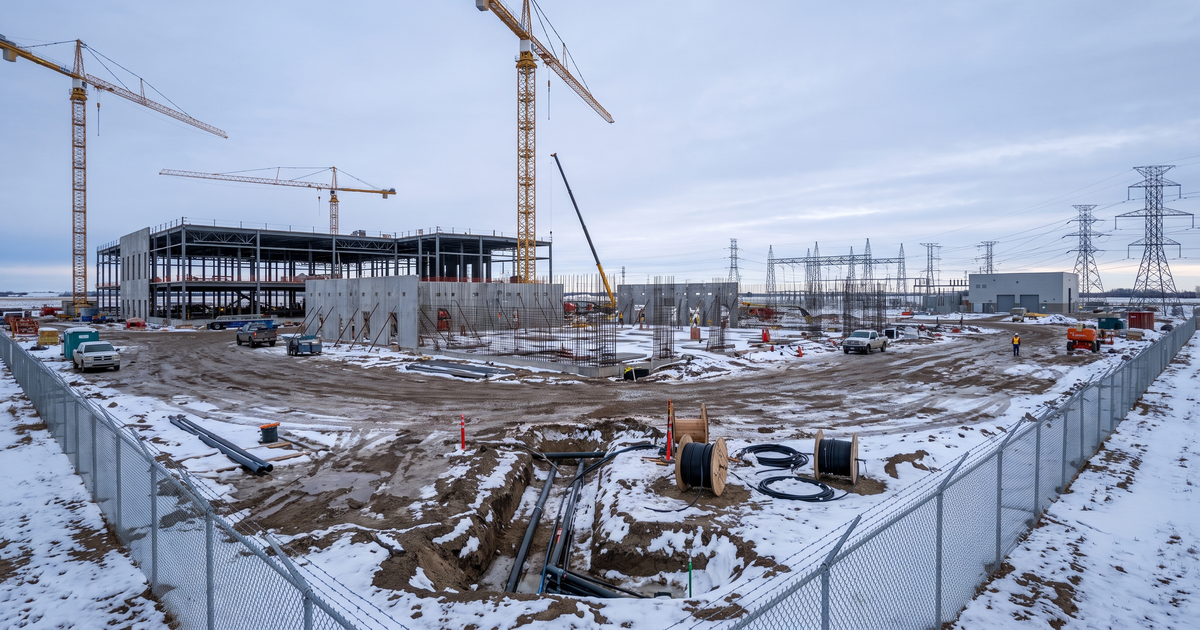

Meta’s Alberta campus has documented civil works and a named Clark/PCL general contractor. Review the power scopes, forecast jobs and prospective low-voltage work.
Updated November 12, 2026. Meta’s Sturgeon County AI data centre now has a clearer construction record and a named route into its delivery team. A November 10 federal response describes civil work underway since June. Meta identifies Frost Collective, the Clark Builders/PCL Construction joint venture, as general contractor. For fibre, security and controls firms, those are useful starting points for researching prospective work on a campus carrying more than CA$13 billion of announced investment.
The immediate opportunity is to understand who buys each package and when that package becomes available. The sources reviewed establish site infrastructure activity and the principal delivery team. They leave specific low-voltage installers, bid deadlines, device quantities and data-hall installation progress unresolved. This update separates those open questions from the project’s documented milestones.
Sturgeon County project snapshot
| Item | Current evidence | Boundary |
|---|---|---|
| Location | Sturgeon County, Alberta | Industrial Heartland |
| Investment | More than CA$13 billion | Announced campus investment |
| Capacity | Approximately 1 GW | Announced; energized load unverified |
| Building area | 2.9 million square feet | Builder’s current description |
| Construction | Civil works since June 2026 | Exact start day unverified |
| Operating target | 2028 | Current county forecast |
| Peak construction | Approximately 3,000 workers | Owner forecast |
| Operations | More than 300 jobs | Owner forecast; vacancies unverified |
Meta’s July announcement describes an AI-optimized campus and investment exceeding CA$13 billion. Sturgeon County’s current project page places roughly CA$60 million of local infrastructure improvements within that investment and shows 2028 as the operational target. All amounts here are Canadian dollars. The announced investment does not provide a priced low-voltage package, a final construction cost or a financing-close receipt.
What the November construction record establishes
The Impact Assessment Agency of Canada’s November 10 response records construction activities ongoing since June 2026. It describes gas pipeline and distribution-line relocation, vegetation clearing, road development, perimeter fencing, topsoil stripping, grading, underground utilities and stormwater facilities. Some activities were completed and others remained underway. This is evidence of physical civil construction, with no exact start day established.
The agency’s stated reason for declining designation was that the physical activity had substantially begun. The response addresses that designation limitation. It does not establish an environmental merits approval, dispose of every municipal appeal or demonstrate that all construction permits are in place. Piling progress and main-building progress remain unverified in the material reviewed.
For contractors, the documented sequence makes coordination with civil and utility work a practical subject for inquiry. Underground routes, entrances and access constraints can affect later communications work. The public record does not identify which routes carry fibre, who owns them or whether installation packages have been released. A productive conversation would establish the current design revision, package boundaries and the organization responsible for answering trade questions.
Who is building the campus?
Meta names Frost Collective as general contractor. The joint venture combines Clark Builders and PCL Construction. Clark’s project page identifies construction management as the delivery method, approximately 1 GW of compute capacity and 2.9 million square feet. It also identifies Stantec and SLB as delivery collaborators. Their specific disciplines, legal contracting entities and installation responsibilities are not detailed there.
| Organization | Verified relationship | Scope limit |
|---|---|---|
| Meta | Owner/operator | AI campus |
| Frost Collective | General contractor | Clark/PCL joint venture |
| Clark Builders | JV delivery partner | Construction management |
| PCL Construction | JV delivery partner | Campus delivery |
| Stantec; SLB | Delivery collaborators | Disciplines unspecified |
| Capital Power | Capacity/energy supplier | 250 MW agreement |
| AltaLink; AESO | Named grid-planning partners | Specific awards unverified |
The project website provides a vendor-interest route and career resources. An interest registration is an early procurement contact point. Contractors still need confirmation of qualification requirements, the purchasing entity, an issued scope and a response deadline before treating a lead as a bid. No submission or project-specific specialty award was verified for this report.
A useful capability statement would explain the work a firm can self-perform, its regional staffing capacity and its relevant project experience. It should distinguish installation from testing, design assistance and commissioning support. Those distinctions help a buyer understand how a team might fit a package. They are preparation suggestions, not published Sturgeon procurement requirements.
Keep the power agreements in their own scopes
Capital Power reports an energy supply agreement covering 250 MW of capacity and energy for more than ten years. It anticipates project load entering service in the second half of 2028. That is a contracted supply figure and forecast service date; it does not establish today’s energized campus load.
Pembina’s Greenlight disclosure concerns a separate 932 MW gas-fired generation project, with a July 2 final investment decision and an anticipated second-half 2030 service date. Pembina, Morgan Stanley Infrastructure Partners and Kineticor are the project partners. Reported cost is approximately CA$4 billion, or CA$4.6 billion including financing. The source describes arranged project debt, EPC agreements with Aecon and Técnicas Reunidas, and Siemens Energy equipment agreements.
Those power-plant contracts do not identify the campus’s electrical or low-voltage subcontractors. The 1 GW campus description, 250 MW supply agreement and 932 MW generation phase cannot be added into a single IT-capacity figure. Their boundaries and schedules differ. Larger potential generation figures also require separate treatment. Buyers evaluating work should establish whether a package belongs to the data centre, transmission infrastructure or the generation plant before assigning it to a sales pipeline.
Where low-voltage work could emerge
Meta’s current fact sheet explicitly names fibre technicians among the trades involved in building data centres and describes network infrastructure investment in the region. That gives fibre and network work a direct owner-source connection. The other systems below are prospective scope analysis. Public evidence reviewed here does not identify their installers, design quantities or tender packages.
| System | Work to investigate | Evidence boundary |
|---|---|---|
| Fibre / outside plant | Routes, handoffs, testing | Owner names fibre/network work |
| Structured cabling | Pathways, labels, turnover | Prospective; quantities unknown |
| Access control / CCTV | Doors, gates, video links | Prospective; award unknown |
| Controls networking | Monitoring and alarm interfaces | Prospective; vendor unknown |
| Fire alarm | Life-safety interfaces | Prospective; design unknown |
| Grounding / bonding | Telecom-space coordination | Prospective; details unknown |
For fibre teams, useful questions concern route ownership, carrier handoff locations, entrance diversity, splice responsibilities and acceptance testing. A crew’s preparation can include connector inspection and cleaning, test-equipment calibration, consistent labelling and trace-file organization. The issued specification must determine the actual test methods and acceptance limits. Public campus size alone cannot establish strand counts or technician hours.
Security contractors should seek clarity on the division between construction-phase security and permanent systems. Gate access, worker access, cameras and operational network connections may have different owners and delivery dates. A project-wide security label is too broad to price responsibly. The useful next document is a scope showing devices, interfaces, responsibilities and the acceptance process.
Controls and life-safety firms face similar interface questions. Equipment status, alarms, network permissions and test sequences need clear ownership among suppliers and installers. These are areas to investigate as design information becomes available. A named collaborator does not by itself establish a controls vendor or an integrator’s appointment.
Meta describes closed-loop liquid cooling with dry heat rejection and no operational water use in the cooling system. Its announcement separately identifies domestic, fire-protection and maintenance water uses. Controls opportunities should be assessed against the issued design. The owner’s annual clean-energy matching commitment also needs its annual qualification; it does not establish hourly fossil-free physical supply.
Jobs, trades and practical preparation
Meta forecasts approximately 3,000 workers at peak construction and more than 300 operational jobs. Its current fact sheet rounds operations employment to roughly 300. These are projected workforce figures, with no verified count of current vacancies. The project’s career links and Clark’s career route are useful places to begin checking actual roles and application requirements.
For technicians, the preparation categories are concrete: fibre inspection and testing, cabling installation, pathway coordination, grounding and bonding, security-system integration and orderly commissioning records. The Fiber Optic Association’s workforce resources offer a general training starting point. Training should be matched to the employer’s requirements and the work being pursued. No specific certification is presented here as a mandatory Sturgeon credential.
Site readiness also requires the employer’s actual onboarding and task requirements. Experience with lifts, utility coordination, controlled access and work documentation can be relevant, but contractors must confirm the applicable site rules. Before relocating or reserving crews, workers and employers need a real position or contract, a reporting location and a credible start window.
Permits, location and the next evidence to watch
An October 20 county notice describes piling-only permit DP-26-0293 for DCB01 and MY01 at 56027 Range Road 223. The notice does not name Meta. Its association with the campus appears in secondary tracking, while the complete owner/parcel chain and appeal outcome remain unverified. It is therefore insufficient evidence to declare Meta’s piling complete.
A September 15 appellant submission identifies Project Frost’s master-site address as 56111 Range Road 223. This is a party filing hosted by an outside organization; its arguments are not tribunal findings. The map location uses that address as an orientation point. It does not define the campus boundary, a hall location or a contractor entrance.
The useful next milestones are documented building progress, resolved permit questions, issued trade packages, named specialty installers and confirmed service dates. Contractors can use those developments to decide when to qualify, estimate and reserve resources. Current evidence supports pursuing informed introductions while keeping staffing commitments tied to actual procurement information.
Follow the project through LVN Signal
Use LVN Signal to research construction opportunities and follow the AI/data-centre project map for location context. Sturgeon’s civil-work record and named GC make it a useful project to investigate. Confirm the buyer, scope and schedule directly before pricing work. Generated artwork accompanying this report is conceptual; it is not verified construction photography.
