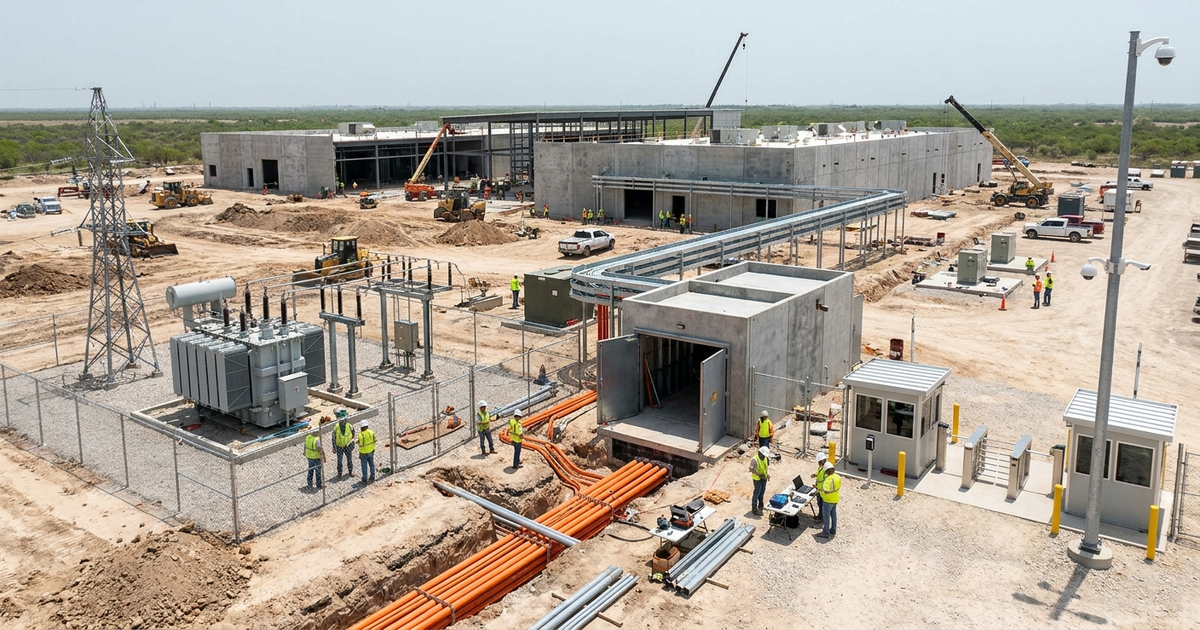

Hut 8’s Beacon Point campus in Nueces County, Texas, has reached a useful construction milestone for contractors tracking AI infrastructure. The owner’s November 4 quarterly update reports substation construction, Phase 1 foundations and underground utilities, and Phase 2 civil design. Initial data-hall deliveries remain targeted for Q3 2027 and Q2 2028. Those different stages matter to low-voltage firms: site coordination can begin well before a building is ready for cable installation.
The opportunity requires careful qualification. Beacon Point has substantial contracted demand and a named delivery team, but public evidence does not identify its electrical, fiber, security or controls subcontractors. The useful next step is to establish package ownership, purchasing responsibility and release dates. This report separates confirmed construction activity from forecasts and identifies the interfaces a prospective specialist should investigate.
Project snapshot: keep each measure in context
| Measure | Reported figure | Meaning |
|---|---|---|
| Location | Nueces County, Texas | Robstown address in state filing |
| Utility capacity | 1,000 MW | Campus interconnection capacity |
| Leased critical IT | 704 MW | Two 352 MW phases |
| Current energized AI load | Unverified | Capacity is not delivered load |
| Base-term lease revenue | $19.6 billion | Two 15-year leases |
| Owner investment estimate | About $17 billion | Data centers plus compute |
| Registered building estimate | About $399 million | One building filing |
| Phase 1 financing | $4.25 billion | Notes closed June 9 |
Hut 8’s July 20 second-lease announcement describes the same confidential, investment-grade tenant across both phases. Each combines 352 MW of critical IT with 500 MW of utility capacity. Exercising every renewal option would raise potential lease value to $50.2 billion. That conditional revenue figure is unsuitable as a construction budget. The tenant remains unnamed; a technology partnership does not disclose who occupies the campus.
The same distinction applies to dates. July’s Q1 2027 initial-energization forecast is a target, while the November report describes ongoing construction. Its statement about initial substation energization at River Bend concerns a separate Louisiana campus. Beacon Point’s current energized AI load remains unverified.
Financing is established for Phase 1
The June 9 financing announcement confirms that Beacon Point DC LLC closed $4.25 billion of senior secured notes. They carry a 6.129% coupon, mature in 2042 and are non-recourse to Hut 8. Stated uses include six halls totaling 352 MW of critical IT, the substation, reserves and fees. This supplies evidence of a financing close for a defined first-phase program.
Phase 2 needs its own financing evidence. The November update says structures were being evaluated. Hut 8’s separate $1.07 billion corporate revolving facility does not establish a Phase 2 construction financing close. Contractors should evaluate the phase behind an opportunity and the actual contracting counterparty before translating campus-level headlines into staffing or purchasing commitments.
The owner’s campus page presents about $17 billion of combined data-center and compute investment for the first two phases. A construction-only total and a defensible low-voltage budget are unavailable. Applying a generic LV percentage to that combined figure would mix servers and other compute spending with building work. This report therefore carries no estimated LV contract value.
A state filing adds building-level detail
Texas registration TABS2027000611, filed September 9, describes a 657,130-square-foot building, guardhouse, fire-water tank and pump, and exterior mechanical and electrical structures. Its estimated cost is $398,985,153, with submitted dates of September 28, 2026 through November 5, 2027. Registration alone establishes neither a building permit nor actual completion.
The street entry is 4650 FM 1694, Robstown, TX 78380; another municipality line says Corpus Christi. Confirm the correct entrance and delivery instructions before dispatching crews. The map currently represents the Robstown locality, not a surveyed parcel. Separately, the owner markets 525 acres while the financing announcement describes approximately 521 acres. Those source descriptions should retain their distinct contexts.
The filing names Beacon Point DC LLC, also identified as Lon Hill Infrastructure LLC, as owner and Jacobs Project Management Co. as design firm. Its supporting structures indicate interfaces worth investigating. They do not identify the eventual security, alarm, communications or controls installer.
The delivery team and the remaining procurement gap
Jacobs’ May 12 announcement confirms a sole-source engineering, procurement and construction management assignment. EPCM is the supported role; a turnkey EPC or general-contractor award should not be inferred from it. Jacobs also describes design reuse from River Bend and digital-twin support for commissioning. Those capabilities make design coordination and documented handoffs relevant discussion points for prospective specialist firms.
| Organization | Supported role | Qualification |
|---|---|---|
| Hut 8 | Owner/developer/operator | Campus sponsor |
| Beacon Point DC LLC | Filing owner; note issuer | Lon Hill alias recorded |
| Jacobs | EPCM lead | Turnkey EPC unverified |
| Jacobs Project Management Co. | Registered design firm | Exact filing identity |
| Vertiv | Critical infrastructure partner | Installer awards unknown |
| AEP Texas | Utility interconnection | Current AI load unknown |
| NVIDIA | Technology / DSX partner | Tenant unverified |
| CCREDC | Regional development partner | Separate from procurement |
| Nueces County | Project jurisdiction | No new approval inferred |
The original owner lease announcement identifies Vertiv, NVIDIA, AEP Texas and the Corpus Christi Regional Economic Development Corporation among the project participants. These roles explain parts of the delivery chain. They do not establish who buys every subcontract package. No reviewed source identifies an awarded electrical, fiber, structured-cabling, CCTV, access-control or BMS installation contract.
For a specialty contractor, that procurement gap defines the research task. Establish whether a package sits with the owner, an electrical prime, a systems integrator or another delivery participant. Ask about the issued scope, bidder requirements, commercial counterparty and schedule. An accurate company profile can help introduce capabilities, but a corporate website or general inquiry contact is not a bid invitation.
Where low voltage may enter the work
The following are LVN’s practical opportunity inferences from the campus type, construction sequence and documented supporting facilities. Quantities, product selections, carrier paths, installer awards and purchasing dates remain unverified. Use these interfaces to frame a qualification conversation; pricing requires an issued scope and agreed responsibility boundaries.
| Interface | Potential work | Confirm first |
|---|---|---|
| Fiber / outside plant | Entrances, pathways, testing | Routes and package buyer |
| Structured cabling | Termination and documentation | Issued quantities |
| Access control / CCTV | Gate, door and video interfaces | Security design and integrator |
| Fire alarm | Life-safety interfaces | Approved design and authority |
| BMS / networks | Controls and alarm integration | Responsibility matrix |
| Grounding / bonding | Telecom-space coordination | Electrical details |
Early underground work makes pathway coordination a useful inquiry. A prospective OSP firm can ask who controls sleeves, duct routing, inspection records and the handoff between civil work and communications installation. It should establish how field changes reach the design team and which drawings govern. None of the public material provides a verified carrier route, duct quantity or cable count.
Inside the buildings, practical preparation includes termination quality, fiber inspection and cleaning, test-result management, labeling and accurate closeout documentation. For prospective security and controls work, establish where network ownership changes between trades and who approves device locations, alarm interfaces and commissioning records. A proposed integration plan should identify dependencies without assuming that one contractor owns every layer.
Commissioning also deserves a commercial discussion before mobilization. Ask who witnesses tests, who resolves failed results, how retests are recorded and which turnover documents are required for payment or acceptance. The value of that preparation is traceability: field installation, test data and final drawings should describe the same work. These are general contractor-readiness considerations, not published Beacon Point specifications.
Jobs, trade preparation and useful resources
Hut 8 forecasts approximately 1,900 construction jobs and 230 operations roles across the first two phases. Its phase figures are roughly 945 construction and 115 operations roles each. Forecasts do not establish current vacancies, hires or the duration of employment. Neither those totals nor the campus’s leased capacity measures how many low-voltage technicians are being recruited today.
For job research, start with Jacobs’ official corporate site and verify each actual requisition’s location, employer, travel expectations and project assignment. General careers pages should not be represented as Beacon Point hiring announcements. For fiber preparation, the Fiber Optic Association’s workforce resources provide background on training and certification. The reviewed project sources do not prescribe FOA credentials or any other campus-specific certification.
Useful preparation for a contractor conversation includes evidence of relevant installations, technician experience, sample test reports and a realistic staffing plan. Ask the buyer to specify insurance, prequalification, safety orientation, lift access, site authorization and manufacturer training requirements. Keep the distinction clear between a capability your team already has, one it can obtain, and one the actual contract requires. Training should follow the role being pursued.
Milestones that would make the opportunity more actionable
The next useful evidence is phase-specific: dated progress updates, confirmed utility milestones, an identified Phase 2 financing close, named package buyers and published procurement schedules. First-hall targets should be checked against later owner disclosures. A construction photo can establish visible progress within its frame; it cannot prove an entire phase is energized or ready for occupancy.
For a small or midsize LV business, the immediate decision is how much qualification effort this project warrants. A short capability brief organized around the relevant interface is a reasonable starting point. Crew reservations, travel and material purchases need firmer evidence of scope, schedule and commercial terms. The absence of a public award leaves the opportunity unresolved; it does not establish that a package remains available.
Follow the project through LVN Signal and use the linked owner, contractor and state records to check new claims. Beacon Point offers a substantial, documented construction program with prospective communications, security and controls interfaces. Turning that into a workable sales lead requires the next layer of evidence: a specific buyer, an issued package and a credible release date.
Updated November 6, 2026. Featured and social artwork are AI-generated concept illustrations. They do not depict a verified site plan, installed equipment or current construction progress.
