Bitdeer broke ground on a 101 MW Fox Creek energy and HPC data centre where contractor package names are still forming.

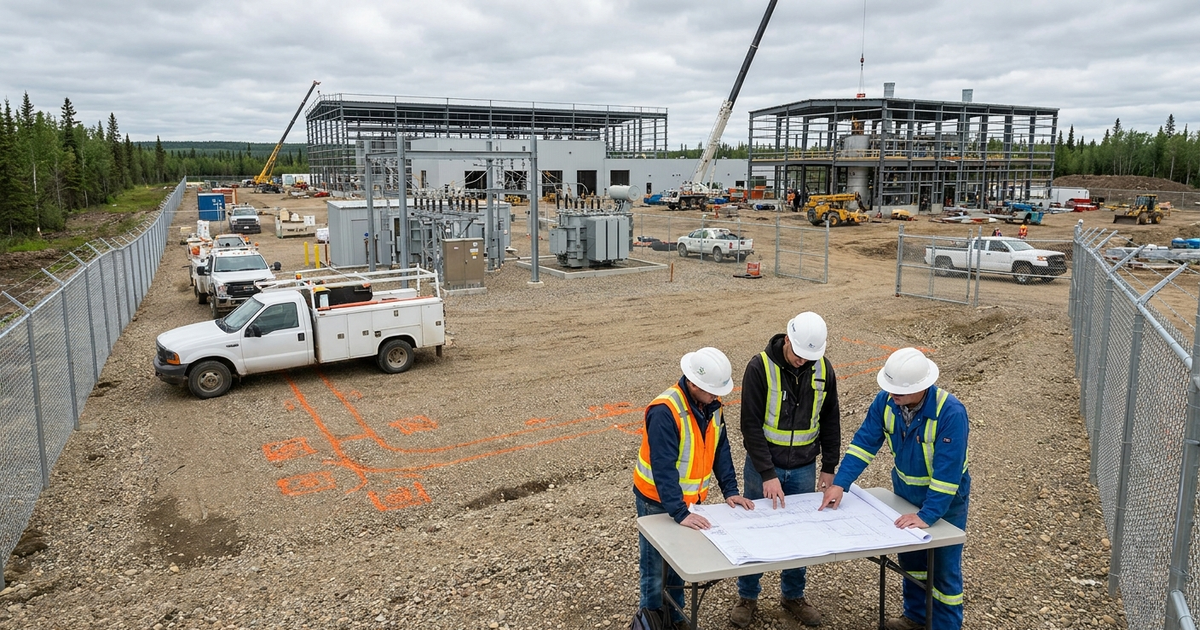

Bitdeer has moved its Fox Creek, Alberta project from permitted power asset to active construction. In a June 2, 2026 announcement, Bitdeer said it broke ground on a vertically integrated energy and high-performance computing facility near Fox Creek. The build pairs a 101 MW natural gas power plant with a data centre offering about 100 MW of computing capacity. Bitdeer describes the site as a bring-your-own-generation configuration, with the data centre powered directly by the on-site plant and supported by an approved 99 MW interconnection to the Alberta Electric System Operator grid.
This is a useful LVN Signal project because it is already under construction, but the specialty contractor layer is not public yet. The owner, power approvals, substation approvals, seller history, local context, job count, and schedule are source-backed. The EPC, general contractor, electrical contractor, low-voltage contractor, fiber/OSP contractor, security integrator, fire alarm contractor, controls contractor, DAS/networking contractor, grounding team, and commissioning firm are not named in the reviewed sources. That means the next public evidence is likely to matter for contractors, vendors, recruiters, and techs trying to position early.
The source trail is strong. The Government of Alberta Major Projects page lists the project as under construction, with a 2026-2027 schedule, estimated cost of C$214 million, and Bitdeer Technologies Group as developer. Alberta Utilities Commission approval 29843-D02-2025 transfers the Opal Power Plant approval to BitDeer Energy Inc. and describes a 101.133 MW flexible natural gas-fired power plant in the Fox Creek area. AUC permit and licence 29843-D03-2025 transfers the Gemini 1008S Substation permit and licence to BitDeer Energy Inc. The earlier Kiwetinohk sale announcement ties the fully permitted Opal power project to Bitdeer, while Regulatory Law Chambers' summary of the ATCO / Kiwetinohk Opal transmission decision gives additional grid-connection context.
The framing needs to stay precise. This is not a pure hyperscale AI campus announcement like a Meta, Google, or Microsoft campus. Bitdeer is explicit that Bitcoin mining is the initial workload for the full generating capacity, while the data-centre infrastructure is designed to retain flexibility for future high-performance computing and AI applications as demand changes. For LVN, that distinction matters. We should not overstate the tenant story, but we also should not ignore the physical scope. A 100 MW compute facility with on-site generation, substation work, secure perimeter, operations staffing, and commissioning needs the same trade discipline that shows up across mission-critical data-centre construction.
The construction opportunity also sits at the intersection of two labor pools. One side is industrial power: gas engines, high-voltage equipment, substation fencing, interconnection, environmental conditions, and electrical safety. The other side is data-centre operations: fiber, structured cabling, facility networking, controls, security, life safety, documentation, and uptime-minded QA. Low-voltage contractors that can work cleanly around power contractors, controls teams, and commissioning agents have an advantage when a project starts as energy infrastructure and becomes a compute facility.
Project Snapshot
| Item | Public Evidence | LVN Takeaway |
|---|---|---|
| Location | Near Fox Creek in the Municipal District of Greenview No. 16, Alberta | Remote campus work creates a watchlist around site access, OSP routes, utility coordination, security, and commissioning logistics. |
| Construction status | Bitdeer announced groundbreaking on June 2, 2026; Alberta lists the project as under construction. | The project has moved beyond announcement-stage tracking into active construction monitoring. |
| Power scope | AUC records describe a 101.133 MW gas-fired Opal Power Plant and Gemini 1008S Substation. | Power, controls, grounding, fencing, security, communications, testing, and turnover documentation will be tightly linked. |
| Compute scope | Bitdeer describes about 100 MW of data-centre computing capacity. | Even with a crypto-first launch, the physical plant still needs mission-critical data-centre infrastructure. |
| Schedule | Bitdeer says energization is planned for Q2 2027; AUC approvals require completion by September 30, 2027 unless otherwise authorized. | The most useful contractor signals should appear during 2026-2027 construction, interconnection, and commissioning windows. |
| Jobs | Bitdeer expects 300 construction jobs and 30 permanent positions. | Alberta-based contractors and techs should watch for package awards, job postings, site onboarding, and safety requirements. |
Named Companies And Public Roles
| Company / Agency | Public Role | Evidence |
|---|---|---|
| Bitdeer Technologies Group | Owner/operator/developer of the Fox Creek energy and HPC data-centre facility. | Groundbreaking announcement and Alberta project listing. |
| BitDeer Energy Inc. | Approval holder for the Opal Power Plant and Gemini 1008S Substation transfers. | AUC approval and substation permit/licence transfer documents. |
| Kiwetinohk Energy Corp. | Original Opal power-project developer and asset seller. | Kiwetinohk's February 2025 sale announcement. |
| Alberta Utilities Commission | Power plant, substation, and regulatory approval authority. | AUC documents 29843-D02-2025 and 29843-D03-2025. |
| Alberta Electric System Operator | Grid operator tied to the 99 MW interconnection and energization certificate language. | Bitdeer announcement and AUC substation permit conditions. |
| ATCO Electric Ltd. | Transmission-connection applicant in the earlier Opal transmission project record. | Regulatory summary of AUC Decision 28658-D01-2024. |
The important gap is just as useful as the named-company list. No reviewed source names an EPC, general contractor, electrical contractor, structured cabling contractor, low-voltage contractor, fiber carrier, security integrator, fire alarm contractor, BMS/BAS controls integrator, DAS contractor, network integrator, grounding contractor, or commissioning agent. The safest way to work this account is to treat those roles as open until a primary source, permit record, contractor page, job posting, or procurement notice names them.
That contractor gap is normal for this phase. Public owner announcements often lead with investment, power, jobs, and schedule. Utility and regulatory filings often lead with equipment, legal land descriptions, operating conditions, and completion obligations. Specialty scopes tend to surface later through job descriptions, vendor pages, local permit records, public inspection logs, social posts from trade partners, or project references added after work is underway. Fox Creek is exactly the type of project where the first useful clue may be a controls technician posting, a security integrator hiring note, a fiber route permit, or a commissioning engineer role that mentions Opal, Gemini 1008S, BitDeer Energy, or Fox Creek rather than a clean marketing name.
For contractors, this is also a reminder to separate named evidence from likely scope. It is fair to say the project will create demand around communications pathways, security, monitoring, controls, and turnover because those systems are inherent to a powered compute campus. It is not fair to attach a company name to those scopes until a source says so. That is why the current watchlist is built around source-backed roles, open packages, and the dates when procurement or staffing signals should begin to appear.
Where Low Voltage Shows Up
| Scope | Why It Matters | Evidence To Watch |
|---|---|---|
| Fiber / OSP | A remote HPC campus needs reliable entrance pathways, diverse routes, carrier handoffs, and clean test records. | Fiber route permits, carrier announcements, duct-bank work, vaults, and OSP contractor posts. |
| Structured cabling | Compute capacity turns into real work through pathways, trays, labels, fiber/copper testing, and documentation. | Interior buildout jobs, rack/row scope, cabling prequal language, and test-equipment requirements. |
| Security systems | Power plant, substation, yard, data-centre shell, and operations zones all need controlled access and camera coverage. | Fence/security package awards, CCTV/access-control integrator roles, guardhouse or perimeter permits. |
| Fire alarm / life safety | Large electrical, fuel, power, and compute environments demand careful interface work with suppression and monitoring. | AHJ submissions, special inspections, FA contractor activity, and commissioning reports. |
| BMS / BAS controls | Controls connect cooling, power, alarm, monitoring, and operational handoff requirements. | Controls integrator jobs, commissioning roles, sequence documentation, trend-log and turnover language. |
| Grounding / bonding | Substation, telecom spaces, racks, pathways, and equipment rooms all depend on disciplined bonding and QA. | Electrical coordination notes, grounding tests, bonding inspections, and commissioning checklists. |
The strongest timing signal is the energization window. Bitdeer says Q2 2027, while the AUC power plant and substation documents carry a September 30, 2027 completion deadline unless the Commission authorizes a change. That gives the market a rough sequence: civil and power work first, then enclosure and support systems, then controls, security, data pathways, integration, testing, and turnover pressure as energization approaches. Low-voltage firms do not need to wait for a glossy announcement to prepare. They need to know which records, keywords, and companies are tied to the project before the public package names are obvious.
Jobs, Skills, And Contractor Readiness
Bitdeer says the Fox Creek project should create 300 construction jobs and 30 permanent positions, with priority for Alberta-based contractors and local operational hiring. That does not mean every low-voltage package is available today. It means the project is entering the period when staffing signals should become visible: site safety requirements, electrical coordination roles, fiber testing, security integration, controls work, and commissioning support.
| Skill Area | Why It Fits | Useful Resource |
|---|---|---|
| Fiber testing and documentation | Data-centre and OSP work rewards clean test results, labeling, certification, and repeatable closeout packages. | BICSI fiber training |
| Structured cabling discipline | Pathways, copper, fiber, labeling, as-builts, and standards-driven installs become critical as rooms and rows come online. | BICSI copper training |
| Fiber workforce basics | Contractors expanding crews need a common baseline for fiber handling, cleaning, testing, safety, and documentation. | FOA workforce resources |
| Site safety | Remote industrial/data-centre jobs require safety paperwork, orientations, lift planning, PPE, and disciplined access control. | OSHA outreach training |
The practical contractor move is to monitor the evidence layer, not guess. Watch Bitdeer and BitDeer Energy Inc. updates, AUC and AESO filings, ATCO-related transmission movement, local Fox Creek and Greenview records, job postings, and contractor pages that mention Opal, Gemini 1008S, Fox Creek, BYOG, AIDC, HPC, or Bitdeer. The first named specialty firms will likely show up through a narrow clue before they show up in a polished announcement.
For LVN members, this is the pattern to recognize: power-first data-centre construction with the technology story still evolving. Bitdeer says the facility is designed for Bitcoin mining at launch while retaining flexibility for future high-performance computing and AI workloads. The low-voltage opportunity does not depend on calling it a pure AI campus. It depends on tracking the real construction systems: fiber, cabling, security, life safety, controls, DAS/networking, grounding, labeling, testing, and commissioning.
LVN Signal is tracking the Fox Creek project as part of the AI/data-center construction intelligence layer so contractors and techs can follow source-backed company names, public records, job signals, and specialty-scope movement while the opportunity is still forming.
