Beacon Indus is a planned four-hall Alberta AI campus with 1,200 MW of proposed supply, an August 18 AUC hearing, named design and power partners, and major fibre, security, controls, fire, and commissioning packages still unresolved.

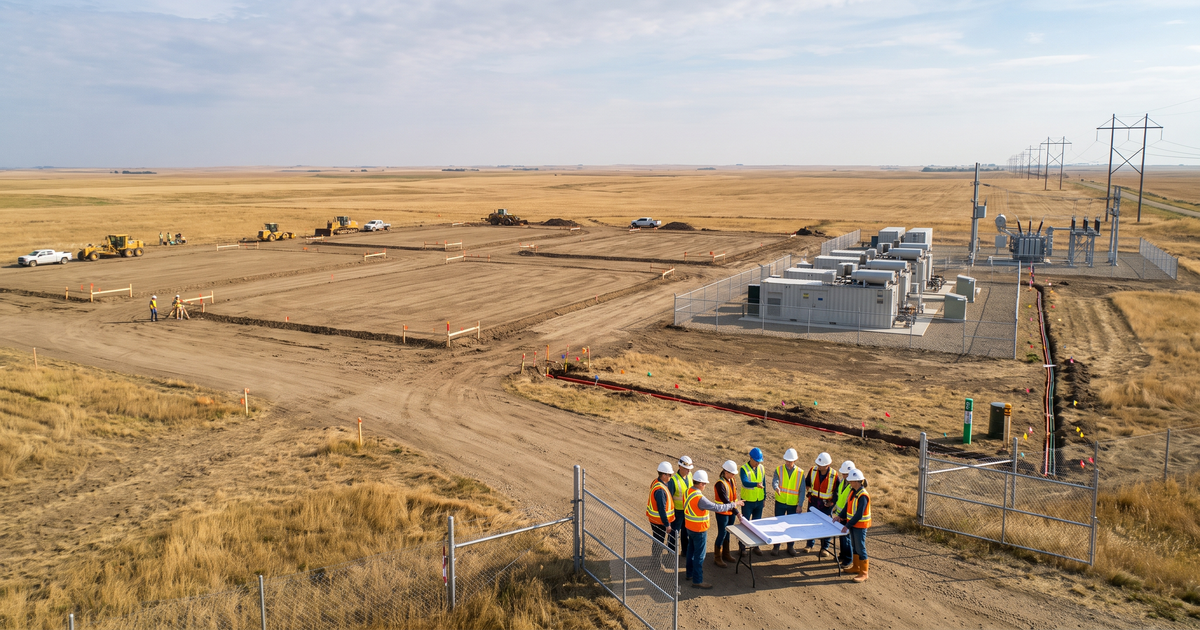

Beacon Data Centers is advancing a large AI and high-performance-computing campus near Indus in Rocky View County, Alberta. The current Beacon campus page describes a 627-acre development, 1,200 MW of planned power, four co-located data halls, on-site generation, fibre connectivity, and a 2028 target for initial operations. The project is still planned. Public records reviewed by LVN do not verify current construction mobilization.
The immediate milestone is regulatory. Alberta Utilities Commission Proceeding 30524 remains under review, and the official notice schedules a virtual oral hearing for August 18, 2026. The application covers a 1,494 MWe thermal power plant intended under normal operations to supply approximately 1,200 MWe to the co-located data halls. An AUC hearing is a serious development signal, but it is not a construction award, notice to proceed, or proof that civil crews are on site.
| Project fact | Current detail | Boundary |
|---|---|---|
| Stage | Planned / AUC review | No verified mobilization. |
| Data halls | Four at up to 300 MWe each | Maximum planned load. |
| Generation | 1,494 MWe installed | Not delivered IT load. |
| Campus power | About 1,200 MWe planned | Supply target, not IT critical. |
| Land | 627-acre campus | ASP frame is about 900 acres. |
| Schedule | 2028 initial operations target | Non-binding owner target. |
| Project cost | Not disclosed | No controlling capex found. |
Capacity reporting needs three separate columns. The 121-page federal project description specifies 1,494 MWe of installed on-site generation, approximately 1,200 MWe supplied to four halls, and a maximum 300 MWe load for each hall. None of those values is an independently verified delivered IT critical-load number. The generation plant includes 100 INNIO Jenbacher J624 engines, 12 Siemens SGT-800 gas turbines, and four Siemens SST-500 steam turbines in the filed design. Those equipment counts describe a proposal under review, not installed inventory.
The public schedule also requires discipline. The December 2025 filing anticipated early civil activity in 2026 and a Q3 2027 in-service target. Beacon's current owner page now points to 2028 initial operations. LVN uses the newer owner target for present reporting while treating both dates as non-binding. Permits, construction notices, procurement releases, energization milestones, and commissioning records will determine the actual sequence.
Land figures come from different planning frames. Beacon identifies a 627-acre campus. Rocky View County's adopted Area Structure Plan covers a broader area described by the County at roughly 900 acres. The Government of Alberta Major Projects record places the project at Section 11, Township 23, Range 28 W4M and identifies Beacon Data Centers as developer, but it publishes no project-cost estimate. LVN does not turn the larger planning boundary into the campus acreage or invent a capex number.
Jurisdiction is split. Rocky View County says it approved the Beacon AI Hub Area Structure Plan in June 2025, while the AUC remains the decision-maker for the power plant and transmission applications. The federal registry recorded a March 2026 decision that no further federal impact assessment was required. That federal decision did not replace provincial approval, County development and building permits, utility agreements, environmental obligations, or later construction authorizations.
| Organization | Source-backed role | Pursuit signal |
|---|---|---|
| Beacon Data Centers | Campus developer | Owner updates and procurement. |
| Indus Power Generation | Power applicant | AUC filings and conditions. |
| Stantec | Design / engineering partner | Design packages and consultants. |
| JouleGrid | Energy / regulatory lead | Permits and power coordination. |
| AltaLink | Planned transmission builder | 240 kV line and substation. |
| Siemens Energy | Specified turbine vendor | Controls, service, commissioning. |
| INNIO Jenbacher | Specified engine vendor | Engine systems and integration. |
Stantec is the clearest named design organization. Stantec says Beacon selected it to provide architecture, building engineering, civil, environmental, geomatics, sustainability, transportation, and project-management services across Beacon's Alberta program. The Indus filing separately references Stantec studies and design inputs. That supports a direct project-team role, while the reviewed sources do not name Stantec as general contractor, EPCM, electrical contractor, or low-voltage integrator.
JouleGrid's direct Indus project page says it leads the regulatory-approval process, permitting roadmap, agency coordination, environmental-assessment work, and the power-delivery strategy. JouleGrid also prepared the federal project description. AltaLink is identified in the filing as the organization expected to design, permit, and construct the 240 kV transmission facilities. The Alberta Electric System Operator remains part of the interconnection and system-access process.
No public source reviewed by LVN names the general contractor or EPCM for the campus. The electrical contractor, fibre and outside-plant contractor, structured-cabling firm, security integrator, fire-alarm contractor, BMS or EPMS integrator, DAS provider, grounding specialist, network integrator, and commissioning authority also remain undisclosed. Named design, regulatory, transmission, and equipment roles should not be expanded into unverified construction awards.
| Low-voltage lane | Filed or owner signal | What to qualify |
|---|---|---|
| Fibre / OSP | Redundant WAN and data-hall feeds | Routes, carriers, vaults, splicing. |
| Structured cabling | Four large data halls | Pathways, racks, labels, testing. |
| Security | Fencing and controlled access | Access, CCTV, gates, VMS. |
| Fire / life safety | Fire-water and safety systems | Alarm interfaces and acceptance. |
| Controls / OT | SCADA, PLC, CEMS, protection | Networks, points, cyber boundaries. |
| DAS / radio | Hardened halls and large site | Coverage and AHJ requirements. |
| Grounding | Ground grids and HV/MV systems | Telecom bonding and test records. |
| Commissioning | Sequential energization plan | IST, turnover, training, closeout. |
The filed design creates a strong fibre and controls signal. It calls for a wide-area fibre network, redundant routes, data-centre feeds, duct banks, SCADA and PLC communications, continuous-emissions-monitoring paths, control wiring, protection systems, and cybersecurity controls. Early outside-plant packages can include duct banks, handholes and vaults, diverse carrier entrances, substation communications, industrial fibre, splicing, optical-loss and OTDR testing, route documentation, and coordination through road, utility, and security boundaries.
Inside the data halls, the likely qualification questions cover backbone fibre, support copper, MMR and IDF pathways, racks and cabinets, ladder rack and cable tray, labelling, test standards, redundancy, data-hall handoff boundaries, monitoring connections, and electronic closeout. Those are practical pursuit lanes supported by the four-hall design and fibre requirements. Public records do not disclose strand counts, connector types, rack density, manufacturers, quantities, tenant standards, or an awarded structured-cabling package.
Security will extend from the property line into mission-critical spaces. The filing identifies perimeter fencing and controlled access points. Future packages can involve vehicle and pedestrian gates, badging, visitor management, intercom, access control, CCTV, video management, storage, perimeter detection, monitoring, and acceptance testing. The actual platform, integrator, device counts, retention rules, cyber requirements, and division-of-work boundary remain unknown.
Fire and life safety will cross the power plant, utility systems, operations buildings, and data halls. The project description identifies fire-protection water reserves and site safety systems, but it does not name the fire-alarm manufacturer or contractor. Contractors should qualify alarm initiation and supervision, suppression interfaces, releasing logic where applicable, HVAC and door interfaces, generator and turbine monitoring, emergency communications, supervising-station paths, cause-and-effect testing, special inspections, and authority acceptance.
Controls and operational technology are central to the project. The filed power campus combines engine and turbine controls, CEMS, a planned 400 MWe substation, 240 kV interconnection, MV and HV switchgear, protection relays, UPS and ATS distribution, and data-hall electrical integration. That points to BMS, EPMS, SCADA, PLC, protection and controls, segmented fibre networks, time synchronization, alarm routing, historian data, metering, point-to-point testing, cybersecurity coordination, and functional verification. It does not reveal the awarded integrators, platforms, protocols, point counts, or responsibility matrix.
Grounding and commissioning will decide whether the electrical and communications systems operate as one campus. The filing identifies grounding grids and sequential energization. Specialty teams should be ready to coordinate telecom bonding, equipment and pathway bonds, substation and building ground references, test records, fibre inspection and cleaning, optical and copper certification, device checks, security acceptance, fire-alarm inspection, controls functional testing, relay and protection testing, network failover, integrated systems testing, issue closure, operator training, and structured turnover.
Beacon's current campus page projects more than 1,500 construction jobs and up to 300 permanent jobs. It also identifies local opportunity across construction, mechanical, electrical, telecommunications, landscaping, and professional services. Those figures are owner projections, not a live hiring count or proof that specific trade packages are open. The useful near-term signals are named constructors, bid portals, prequalification notices, supplier outreach, development permits, and job postings tied directly to Indus.
Useful readiness paths include BICSI optical-fibre training, BICSI copper training, FOA workforce resources, and OSHA outreach training. Project-specific onboarding may also require Alberta trade credentials, site-safety orientation, fall protection and lift access, background screening, strong safety metrics, bonding and insurance, BIM coordination, manufacturer authorizations, calibrated test equipment, and mission-critical references. No reviewed Beacon source mandates that exact list.
The next actionable records are the August 18 AUC hearing transcript, undertakings, conditions, and decision; Rocky View County development and building permits; AltaLink and AESO interconnection milestones; gas-lateral allocation; equipment procurement; a GC or EPCM announcement; trade prequalification; energization; and commissioning jobs. Those records should clarify when the project moves from planned infrastructure into bid-ready and active construction packages.
Bottom line: Beacon Indus is a high-confidence planned AI campus with an owner-backed 627-acre and 1,200 MW frame, a detailed 1,494 MWe generation application, four maximum-300-MWe data halls, source-backed design and regulatory partners, and an imminent AUC hearing. The low-voltage opportunity is broad and technically specific. The current contractor map is incomplete, and the project should remain planned until permits and field evidence verify mobilization.
